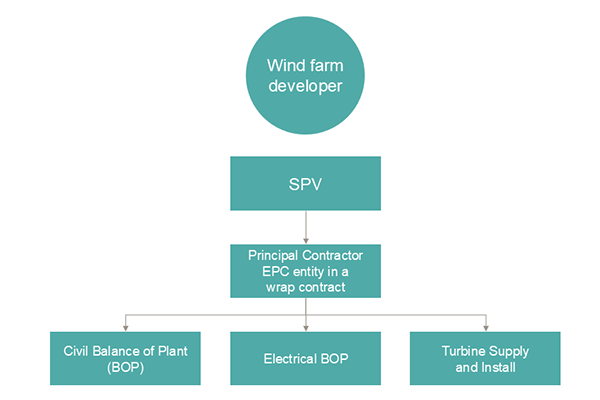

The shift in delivering renewable energy projects away from engaging a single contractor who takes full responsibility for the engineering, procurement, and construction aspects of a project (EPC contract model) to instead developers contracting directly with multiple specialised contractors for separate packages of work (split contract model) raises interesting issues concerning satisfying the principal contractor requirements under work health and safety (WHS) legislation.
Key issues include identifying which entity (or entities) will be appointed as Principal Contractor, determining what works fall under their management and control, and ensuring these arrangements are properly documented within contracts and safety management systems.
Issues concerning Principal Contractor appointment have the potential to lead to disputes between parties, significant disruption and delay, and legal proceedings against entities and individuals for alleged breach of WHS legislation. There is particular liability exposure for the principal / developer given any invalid engagement of a party as a Principal Contractor is likely to mean that the principal / developer is deemed the Principal Contractor. Understanding and addressing these issues is critical for effective project delivery and for managing exposure to criminal liability under WHS legislation.
Principal contractor appointment
The term ‘Principal Contractor’ is defined in clause 293 of the WHS Regulations which relevantly provides:
- A person conducting a business or undertaking (PCBU) that commissions a construction project is, subject to this regulation, the Principal Contractor for the project.
- If the person referred to in subregulation (1) engages another PCBU as Principal Contractor for the construction project and authorises the person to have management or control of the workplace and to discharge the duties of a Principal Contractor under this Chapter, the person so engaged is the Principal Contractor for the project.
- A construction project has only one Principal Contractor at any specific time.
Clause 292 of the WHS Regulations defines a “construction project” as “a project that involves construction work where the cost of the construction work is $250,000 or more.”
The WHS Regulations impose a range of additional duties on a Principal Contractor (in addition to those of a PCBU). As set out above, these duties come into existence when there is construction works occurring that cost $250,000 or more and there can only be one Principal Contractor in relation to those defined works at any one time. Further, the Principal Contractor must have management or control of the workplace and discharge the duties of a Principal Contractor in relation to its works.
Principal Contractor appointment in a split contract model
There are different ways of satisfying the Principal Contractor duties under the WHS Regulations in a split contract model, including with one or multiple Principal Contractors. In considering the different options, developers need to consider which contractors have the competency to fulfil the Principal Contractor duties under the WHS Regulations, whether there are any contractors who would accept Principal Contractor responsibilities for another contractor’s scope of work or for the entire development, and whether the contractors can be given the necessary management and control of the workplace to meet the requirements for Principal Contractor appointment under the WHS Regulations.
Key issues and risks arising from the different approaches to Principal Contractor appointment in a split contract model are outlined below:
Approach to Principal Contractor appointment in a split contract model |
Key issues/risks |
|
One Principal Contractor (being one of the contractors who is undertaking development works) |
- Raises a legal risk issue as to the validity of the appointment regarding whether the contractor who is engaged as Principal Contractor in fact has control of the works for which they are engaged as Principal Contractor.
- Creates the possibility of disputes if the contractor that is the Principal Contractor does not have a direct enforceable contractual relationship with the other contractors (ie a separate coordination and interface deed).
|
|
Multiple Principal Contractors appointed for separate packages of work
|
- This approach has become more common on complex infrastructure developments, and it is contemplated in guidance published by WHS Regulators in some jurisdictions.
- Having multiple Principal Contractors increases the risk of uncertainty (and therefore disputes) regarding which entity is the Principal Contractor for a particular activity. This requires careful contractual drafting and coordination between the Principal Contractors.
- Raises the risk of WHS regulator interactions with the project if the WHS regulator disagrees with the definition of any of the packages of work as a “construction project” within the meaning of the WHS regulations.
|
|
One Principal Contractor (being a third-party project manager)
|
- Same as the first option, but higher risk, including because of the difficulties with an independent third party performing at the level required in such a significant role and the difficulties with enabling effective management and control by the third party of the contractors (this is achieved through the developer’s contracts with the project contractors, but can be difficult to achieve in practice).
|
|
|
|
|
Mitigation measures to address these risks include:
- Clear contractual provisions giving effect to the matters required for effective Principal Contractor appointment under the WHS Regulations that align with the agreed approach to Principal Contractor appointment.
- Development (and careful implementation) of safety systems and processes that support the approach to Principal Contractor appointment. If there are multiple Principal Contractors, this includes systems that provide clarity as to where management and control starts and ends for each Principal Contractor and how Principal Contractor responsibilities will be satisfied and risks managed at each interface.
- Supportive and cooperative engagement with the WHS regulator regarding Principal Contractor appointment. While a WHS regulator does not have the power to formally “approve” or “reject” a Principal Contractor model, in our experience, WHS regulators welcome transparency and engagement to assist them in effectively implementing their regulatory duties.
